Indoor Hitting Facility

Hitting Facility at Glencoe HS


Thursday, January 3rd, 2019

Saturday, December 6th, 2018

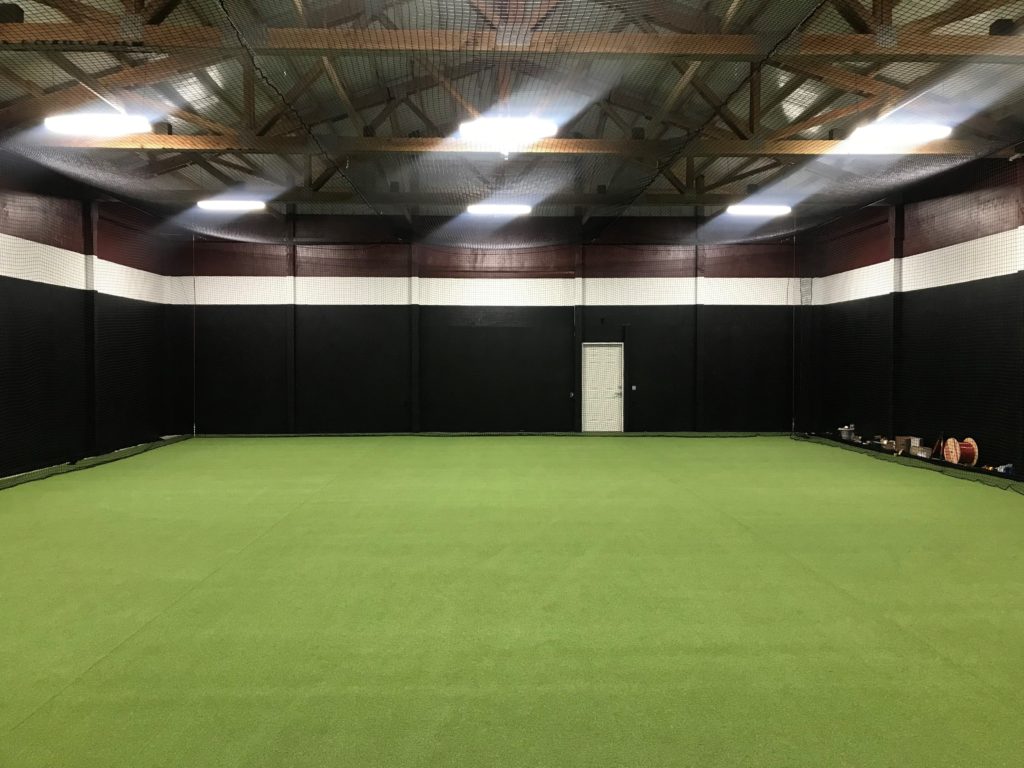

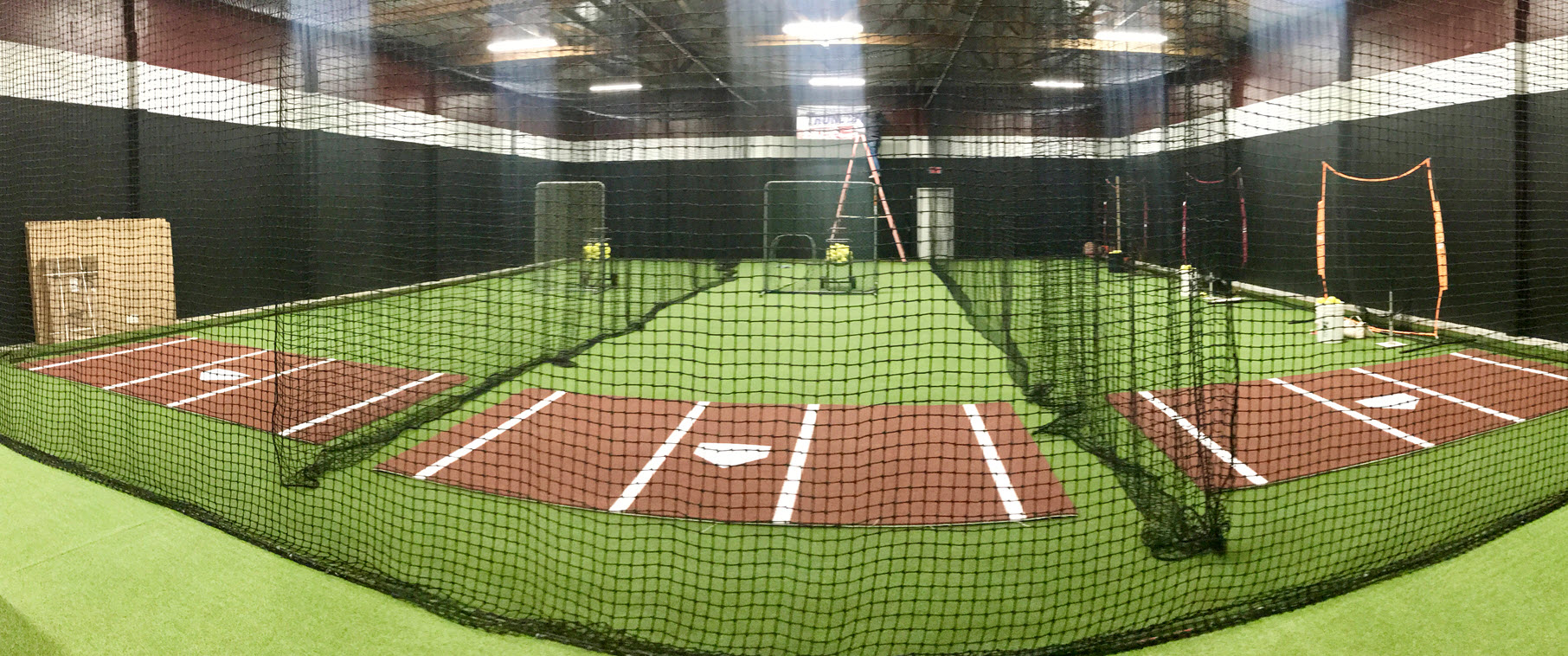

Net install Completed



Saturday, November 29th, 2018
Net install starts

Wednesday, November 14th, 2018
Painting completed by Maller Painting

Monday, October 22nd, 2018
Plywood install complete

Thursday, September 27th, 2018
Plywood install starts

Tuesday, September 25th, 2018
Plywood delivered

Sunday, September 23rd, 2018
Old Glory raised



Monday, September 10th, 2018
Flooring Delivered



Sunday, September 2nd, 2018
Electrical Install starts.

Thursday, August 23rd, 2018
Concrete day!



Tuesday, May 29th, 2018
Gravel delivered to get ready for Concrete.

Monday, May 6th, 2018
Econ-O-Fab Finishes construction on the girls 72’x48’ Hitting Facility

Monday, April 23rd, 2018
Econ-O-Fab starts construction on the girls 72’x48’ Hitting Facility

Sunday, March 3rd, 2018
New Gasline trench dug for NW Naturals main gasline move that feeds the school.

Friday, January 18th, 2018
Pacific INT-R-TEK inspected 24” corrugated steal drain line under proposed building and passed.



Thursday, December 21st, 2017
Northwest Natural Gas Line found and will need to be moved.



Monday, November 6th, 2017
Gravel was brought in and leveled

Friday, November 3rd, 2017
After almost a year working with the City’s permitting process the facility broke ground!

*Thursday, August 17th, 2017
Building Plan Review completed by the City of Hillsboro

*Thursday, June 22nd, 2017
Design Review Narrative completed by BBL Architects

*Monday, June 5th, 2017
Design Review Narrative completed by NW Engineers

*Wednesday, May 16th, 2017
Type II/Development Review Application completed by City of Hillsboro

Tuesday, November 8th, 2016
Approval from the District to move forward with current location

*Wednesday, June 3rd, 2015
Buildings Architectural Design completed by Alliance Engineering
